Hello,
I took Oliver Lehmann 100 questions and scored 68%. Need some insights on a) how do you see my performance (I know that mock test scores are not the right way to judge if we are ready. Just wanted to baseline with other PMP students who passed 1st time) b) insights on following questions.
Appreciate your help and response.
1) You found the following earned value analysis information for a project that was recently closed-out:
SPI = 0.7, CPI = 1.0
Options
The project has been cancelled while it was executed. At that time the project was behind schedule and on budget.
The project's deliverables have all been finished. The project came in behind schedule but on budget.
The project's deliverables have all been finished. The project came in ahead of schedule but on budget.
The project's deliverables have all been finished. The project came in on schedule but over budget.
How is answer Option A? In other words how do you determine if the project is closed mid way or executed until the end.
2) Question on Point of Total assumption, break point - Can you refer me a webpage/video tutorial where I can learn about this?
3) Start dates in the following network logic diagram are defined as early morning, finish dates are evening. If tasks are scheduled to begin at early start date, what is true?

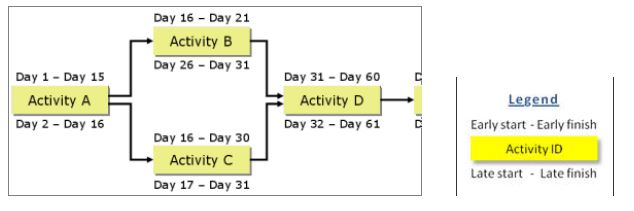

Refer image attached - Question3.jpg
Options
Activity B has a free float of 10 d.
Activity B has a total float of 10 d.
Activity A has a free float of 10 d.
Activity A has a total float of 10 d.

4) A project manager made 3-point estimates on a critical path along a sequence of activities A through E and found the following results:
Refer image attached - Question4.jpg
Assuming ±3 sigma precision level for each estimate, what is the calculated standard deviation of the allover path?
Options
App. 4.2 days
App. 5.2 days
App. 6.2 days
You can not derive the path standard deviation from the information given.
